Outage in Bay of Plenty fibre network – We’re working fast to get you back on line

We are scheduled to start extending our fibre network into your region

Over the next few months our network build will commence and you will soon have access to New Zealand’s fastest broadband connection.†

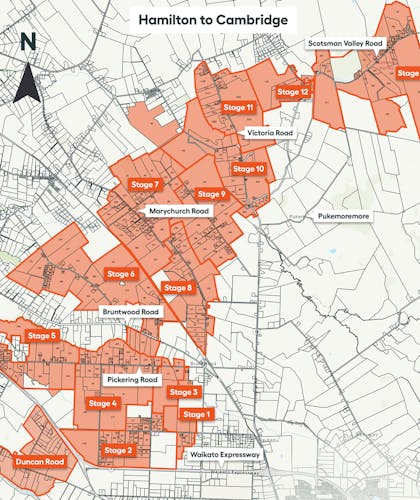

To find out if your address is included, refer to the area maps below.

Secure your fibre installation while we’re still working in your area

Did you know that you can get ahead of the queue and avoid delays by booking a Get Fibre Ready Pre-installation? This means that we will install fibre from the street to your home at the same time as we are completing our fibre network.

To find out more about the build and the installation process, see our FAQs

Secure your fibre installation here

Fibre network build schedule

The network extension for Hamilton started April 2022 and will be completed by March 2023. For more detailed timing, please refer below.

Stage 1 – Fibre is now here!

Contact your preferred internet service provider today and request fibre broadband.

Stage 2

Network build:
18 April 2022 – 15 June 2022

Free installation:
Book your Get Fibre Ready Pre-installation by 15 June 2022*.

Order fibre:
You will be able to place an order for a fibre plan with your preferred internet service provider from 1 September 2022.

Stage 3

Network build:
5 July 2022 – 15 July 2022

Free installation:
Book your Get Fibre Ready Pre-installation by 15 July 2022*.

Order fibre:
You will be able to place an order for a fibre plan with your preferred internet service provider from 1 October 2022.

Stage 4

Network build:
14 July 2022 – 15 September 2022

Free installation:
Book your Get Fibre Ready Pre-installation by 15 September 2022*.

Order fibre:
You will be able to place an order for a fibre plan with your preferred internet service provider from 1 October 2022.

Stage 5

Network build:
18 August 2022 – 19 September 2022

Free installation:
Book your Get Fibre Ready Pre-installation by 19 September 2022*.

Order fibre:
You will be able to place an order for a fibre plan with your preferred internet service provider from 1 November 2022.

Stage 6

Network build:
20 September 2022 – 21 November 2023

Free installation:
Book your Get Fibre Ready Pre-installation by 21 November 2023*.

Order fibre:
You will be able to place an order for a fibre plan with your preferred internet service provider from 1 January 2023.

Stage 7

Network build:
22 November 2022 – 26 January 2023

Free installation:
Book your Get Fibre Ready Pre-installation by 26 January 2023*.

Order fibre:
You will be able to place an order for a fibre plan with your preferred internet service provider from 1 March 2023.

Stage 8

Network build:
8 July 2022 – 15 August 2022

Free installation:
Book your Get Fibre Ready Pre-installation by 15 August 2022*.

Order fibre:
You will be able to place an order for a fibre plan with your preferred internet service provider from 1 September 2022.

Stage 9

Network build:
1 August 2022 – 6 September 2022

Free installation:
Book your Get Fibre Ready Pre-installation by 6 September 2022*.

Order fibre:
You will be able to place an order for a fibre plan with your preferred internet service provider from 1 October 2022.

Stage 10

Network build:
4 October 2022 – 15 November 2022

Free installation:
Book your Get Fibre Ready Pre-installation by 15 November 2022*.

Order fibre:
You will be able to place an order for a fibre plan with your preferred internet service provider from 1 December 2022.

Stage 11

Network build:
29 July 2022 – 16 September 2022

Free installation:
Book your Get Fibre Ready Pre-installation by 16 September 2022*.

Order fibre:
You will be able to place an order for a fibre plan with your preferred internet service provider from 1 November 2022.

Stage 12

Network build:
1 January 2023 – 1 April 2023

Free installation:
Book your Get Fibre Ready Pre-installation by 1 April 2023*.

Order fibre:
You will be able to place an order for a fibre plan with your preferred internet service provider from 1 April 2023.

Stage 13

Network build:
17 August 2022 – 6 October 2022

Free installation:
Book your Get Fibre Ready Pre-installation by 6 October 2022*.

Order fibre:
You will be able to place an order for a fibre plan with your preferred internet service provider from 1 December 2022.

Duncan Road, Cambridge

Network build:
1 June 2022 – 29 July 2022

Free installation:
Book your Get Fibre Ready Pre-installation by 16 August 2022*.

Order fibre:
You will be able to place an order for a fibre plan with your preferred internet service provider from 1 September 2022.

†For more information visit fibre performance.

*Charges may apply for driveways greater than 200 meters for the additional network equipment required to complete your fibre connection. For standard free installation terms and conditions visit free install. Dates are subject to change.
